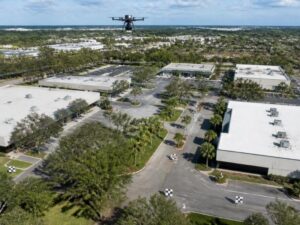

Drone Surveying for Multi-Building Properties
One building is simple to measure. Put a dozen on the same site and small errors start stacking up. Drone surveying handles that scale well, since a single set of flights can map every roof, drive lane and pad across the property at once. That shared frame of reference is what keeps a multi-building project from drifting out of alignment.
Apartment campuses, industrial parks and phased commercial sites all share the same problem. The buildings get measured well. The relationships between them do not.
Why Multi-Building Sites Cause Trouble
Work on a large property rarely happens all at once. One structure gets measured in spring, another in fall, sometimes by a different crew. If each visit ties back to different reference points, the pieces will not line up cleanly when someone tries to combine them.
Grades make it worse. Water moves across the whole site, not building by building. A design based on stitched-together data can send runoff toward the wrong structure.
A drone flight solves the timing problem. Everything gets recorded the same day, under the same control, in the same coordinate system.
Control Comes Before the Flight
The drone is the easy part. Accuracy comes from the ground control network your surveyor sets before takeoff. Without it, the imagery looks great and measures poorly.
What Good Control Looks Like
Ground control points are marked targets with known coordinates, placed across the site so the drone data can be tied to real positions. On a multi-building property, they belong throughout the site rather than clustered near the office. Spread them across the full footprint, including corners and any change in elevation.
Ask for checkpoints too. These are extra surveyed points held back from processing and used to test the finished data. They give you a real accuracy number instead of a promise.
Confirm the vertical datum in writing. Site drainage and building floor elevations depend on it, and mixing datums across phases creates expensive confusion later.
What the Data Shows Across Several Structures
A processed flight gives you the site as one connected model. For a property with many buildings, the useful outputs include:
- Building footprints and roof heights for every structure
- Real spacing and separation between buildings
- Parking layout, stall counts, curb lines and drive aisles
- Existing ground surface with contours across the whole site
- A point cloud you can measure between any two structures
That last item carries the most weight during design. Distance between building three and building seven is a question nobody can answer from a tape measure and an old site plan.
Camera or LiDAR
Drones carry either cameras or LiDAR sensors, and the two produce different results. Cameras build a surface from overlapping photos. LiDAR fires laser pulses and measures return timing.
For open sites with lots of pavement and clear roofs, camera work is usually enough and costs less. It maps what it can see from above.
LiDAR earns its price under tree cover. Pulses can slip through gaps in a canopy and reach the ground below, which matters on older properties with mature trees between buildings. It also handles thin features like fences and power lines better.
Ask which sensor your surveyor plans to use and why. If the answer is vague, that’s a problem.
Flying Over an Occupied Property
Most multi-building sites have tenants, employees and moving cars. US operators fly under FAA Part 107 rules, and flights over people or moving vehicles carry extra requirements. Your surveyor should explain how they plan to handle that before the crew shows up.
Practical steps that keep the day smooth:
- Notify tenants and property management ahead of the flight
- Schedule around peak parking hours if you want clean pavement in the imagery
- Fly mid-morning or mid-afternoon to limit harsh shadows between tall buildings
- Check wind conditions, since air moves oddly around clustered structures
- Confirm roof access is not needed, or arrange it early if it is
Using the Same Data Through Each Phase
Order the first flight before design starts. That gives your team existing conditions for every structure at one point in time.
Fly again during construction to track progress and compare built positions against the plan. Catching a pad in the wrong spot during week six beats finding it at closeout. Repeat flights also produce good documentation for lenders and partners.
Drone data supports as-built work, but it does not replace certified ground survey for everything. Some certifications and final elevation records require direct field measurement. Sort out which deliverables need what before you build a schedule around the flights.
Limits You Should Know
Drones map surfaces. They do not see inside buildings, and they cannot locate underground utilities. Those need separate services.
Dense canopy still causes gaps for camera-based work. Very tall structures can shadow nearby ground and reduce detail on one side. And accuracy claims mean little without control and checkpoints behind them.
Multi-building properties often create problems in the spaces between structures, not the structures themselves. A controlled drone survey records those spaces once, cleanly, for everyone working on the site. Order it early and reuse it through every phase.
Frequently asked questions
How long does a drone survey take on a multi-building property?
Field work on most sites takes one day, sometimes two for very large campuses. Setting ground control usually takes longer than flying. Processing and drafting add roughly one to three weeks, depending on the deliverables. Ask for a schedule that separates field time from office time.
Is drone data accurate enough for site design?
With proper ground control and checkpoints, results are accurate enough for grading and layout work on most projects. Accuracy drops quickly without that control. Request the checkpoint report rather than accepting a general accuracy statement. Match the stated tolerance to what your engineer needs.
Can a drone map building interiors?
No. Standard drone surveying records outdoor surfaces from the air only. Interior spaces require terrestrial scanning or measured field work inside each structure. Some firms offer both, so ask if you need indoor and outdoor data combined.
Do we need to close parking or restrict access during flights?
Usually not. Most flights can be planned to avoid extended operations directly over people and moving vehicles. Clear parking helps the imagery but is not required. Your surveyor should confirm the plan for your specific site before the flight date.
How often should we schedule repeat flights?
That depends on the pace of construction and what you need to track. Monthly flights work well for active vertical construction across several buildings. Quarterly is often enough for slower phases or long entitlement periods. Set the interval at kickoff so the budget accounts for it.
